Reoccupancy Planning After Commercial Property Damage: Why Recovery Should Be Designed Backward

Published September 19, 2026 · Commercial Water Damage Restoration Team · Reoccupancy & Safety

chatgpt image sep 12, 2026, 03 01 41 am

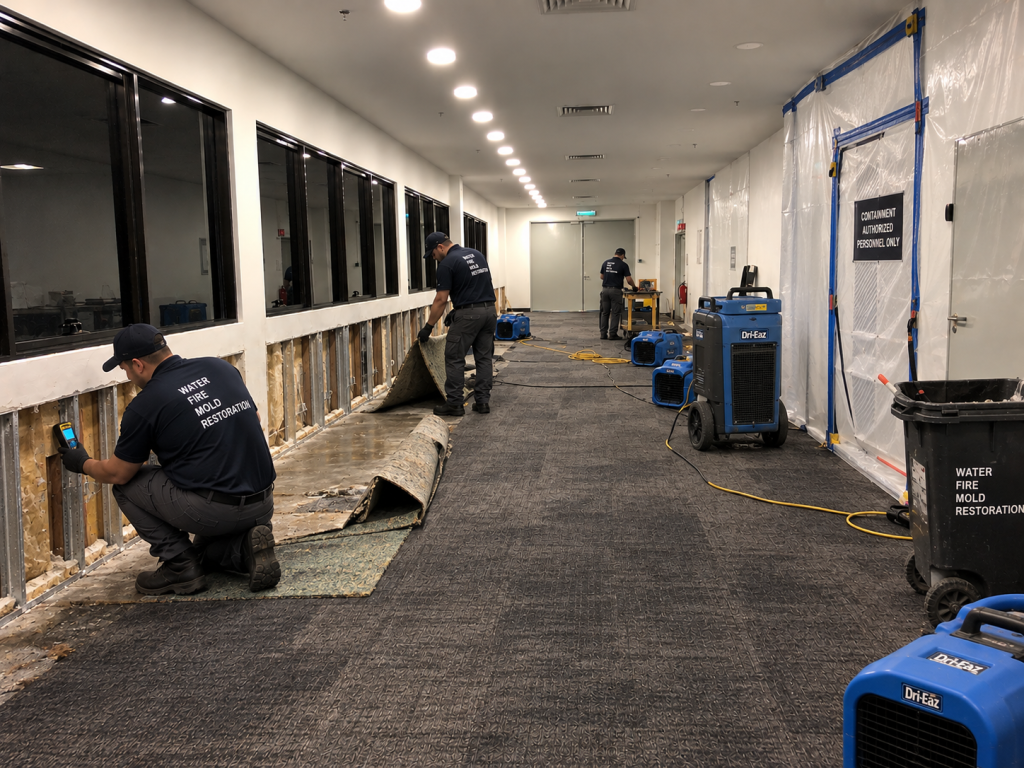

Confirming conditions before drying equipment comes down. Reoccupancy planning starts by defining exactly what the finished space needs to do.

Most commercial restoration plans begin where the damage occurred.

Water entered here.

Drywall is wet here.

Flooring needs removal here.

Equipment was affected here.

So crews naturally begin with the damage and work forward.



Damage

→ Mitigation

→ Drying

→ Reconstruction

→ Completion

→ Reoccupancy



That sequence makes sense from a construction perspective.

But a commercial building does not exist simply to contain walls, flooring and mechanical equipment.

It exists to perform a function.

A hotel accommodates guests.

A warehouse moves products.

A manufacturing facility produces goods.

An office supports employees and organizations.

A retail property serves customers.

That creates another way to design commercial recovery.

Instead of starting only with:

“What was damaged?”

start at the other end:

“What must be true for this business, floor, department or property to operate again?”

Then work backward.



Reoccupancy requirements

→ operational requirements

→ building-system requirements

→ construction requirements

→ restoration priorities

→ today’s actions.



This is backward-designed commercial recovery.

And it can completely change what gets restored first.

water damage repair restoration equipment home & buisness mitigation drying company (12)

Commercial Water Damage Repair

Find the Leak Before It Spreads

Commercial Water Damage Restoration

Dry the Building, Not Just the Surface

Emergency Water Extraction

Fast Response for Burst Pipes

Commercial Flood Damage Recovery

Commercial Water Damage Cleanup

Navigate the Insurance Process

Warehouse Water Damage Recovery

Keep Business Moving During Recovery

Map the Moisture You Cannot See

California Commercial Water Damage

Office Water Damage Repair

Find a Commercial Restoration Contractor

Start With the Finish Line

Imagine a 500,000-square-foot distribution facility experiences significant commercial water damage.

A conventional restoration plan might divide the work geographically.

Area A.

Area B.

Area C.

Administrative offices.

Loading area.

Storage areas.

That describes the building.

Operations may see something completely different.

To resume shipping, the facility needs:

  • Electrical power
  • Warehouse management systems
  • Communications
  • Material-handling equipment
  • Safe employee access
  • Product access
  • Loading docks
  • Lighting
  • Fire/life-safety systems
  • Certain critical operating zones

Now the recovery plan has a destination.

Resume shipping.

From there, the team can work backward to determine exactly what prevents shipping from happening.

The Facility Manager’s Recovery Guide

Texas Commercial Water Damage

Retail Water Damage Recovery

Commercial Property Water Damage

Industrial Water Damage Recovery

Professional Water Extraction

Commercial Recovery Insights

Water Damage Help for Property Managers

When Fire Sprinklers Flood the Building

Commercial Building Drying

Why Old Restoration Signals Fail

Washington Commercial Water Damage

Nevada Commercial Water Damage

Remove Moisture Beneath the Surface

Commercial Water Mitigation

Commercial Water Extraction

Restoration, Repair or Mitigation?

Reoccupancy Is an Operational Condition, Not a Construction Percentage

Suppose reconstruction is 80% complete.

Can the building reopen?

Maybe.

Maybe not.

Now suppose reconstruction is only 50% complete.

Can part of the building reopen?

Possibly.

Construction percentage does not answer the question.

The more important measurement is:

Are the conditions necessary for the intended operation available?

A warehouse may still contain unfinished office reconstruction while shipping returns to near- normal capacity.

Conversely, an office building can look nearly finished while one unresolved elevator, electrical or life-safety dependency prevents meaningful occupancy.

Construction completion and operational readiness are different measurements.

What Restoration Professionals Watch

Seattle Commercial Water Damage

Bellevue Commercial Water Damage

Arizona Commercial Water Damage

San Diego Commercial Water Damage

Emergency Water Damage Response

How Restoration Accountability Works

Walnut Creek Commercial Water Damage

Carlsbad Commercial Water Damage

Katy Commercial Water Damage

Redmond Commercial Water Damage

Pennsylvania Commercial Water Damage

Tacoma Commercial Water Damage

Sugar Land Commercial Water Damage

The Woodlands Commercial Water Damage

Colorado Commercial Water Damage

Fremont Commercial Water Damage

Oakland Commercial Water Damage

San Francisco Commercial Water Damage

commercial water damage restoration contractor repair cleanup company (7)

Define Exactly What “Reopen” Means

One reason reoccupancy planning becomes vague is that the objective itself is vague.

“Reopen the building” can mean many things.

Does reopening mean:

Employees can enter?

Customers can enter?

50% of production can resume?

All tenants can return?

One hotel wing can accept guests?

Warehouse shipping can restart?

The property can return to full normal operations?

Those are different recovery milestones.

Before creating the plan, define the objective.

A useful reoccupancy target might be:

Restore Floors 5–8 for normal office use while reconstruction continues on Floors 2–4.

Or:

Restore outbound warehouse shipping at 70% capacity within the earliest practical recovery window.

Now the project has something specific to design toward.

San Jose Commercial Water Damage

Philadelphia Commercial Water Damage

Houston Commercial Water Damage

Commercial Roof Leak Recovery

Cambridge Commercial Water Damage

South San Francisco Water Damage

Vista Commercial Water Damage

King of Prussia Water Damage

Pasadena Commercial Water Damage

Kent Commercial Water Damage

Reno Commercial Water Damage

Boston Commercial Water Damage

Commercial Building Water Damage

commercial water damage restoration contractor repair cleanup company (11)

One Commercial Building Can Have Multiple Finish Lines

Large properties rarely need one universal reopening date.

A hotel can have:

Guest-room reoccupancy

Lobby reopening

Restaurant reopening

Conference-space reopening

Full property normalization.

A manufacturing facility may have:

Critical production

Secondary production

Warehouse operations

Administrative operations

Full capacity.

An office building might have:

Priority tenant return

Floor-by-floor occupancy

Shared amenity reopening

Full building occupancy.

Each finish line can have a different dependency chain.

That means one commercial property can require several backward-designed recovery plans operating simultaneously.

Work Backward From the Business Function

Suppose the objective is:

Reopen Floors 6–10 of an office building.

Ask what those floors need.

Occupancy

requires:

→ safe access

→ required utilities

→ HVAC

→ electrical power

→ communications

→ appropriate life-safety systems

→ usable restrooms

→ elevators where necessary

→ appropriate separation from restoration work.

Now ask what those systems depend upon.

Elevators may depend on electrical infrastructure.

HVAC may depend on electrical power, controls and mechanical equipment.

Access may depend on unaffected corridors and lobbies.

Life-safety systems may depend on components located inside the damaged zone.

The backward map begins revealing the actual recovery priorities.

The Reoccupancy Dependency Chain

A useful model is:

DESIRED BUSINESS FUNCTION

↓

OCCUPANCY REQUIREMENTS

↓

OPERATIONAL DEPENDENCIES

↓

BUILDING SYSTEMS

↓

CONSTRUCTION REQUIREMENTS

↓

RESTORATION REQUIREMENTS

↓

TODAY’S PRIORITIES

This is the Reoccupancy Dependency Chain.

Instead of asking what construction task happens next simply because it appears next on a conventional schedule, ask: Read more about how warehouse restoration works if reoccupancy planning is a concern for your property.

Which task unlocks the next important operating condition?

That question can completely reorder the project.

Restoration Priorities Look Different When Viewed Backward

Imagine a hotel with significant water damage.

Several corridors require new finishes.

Thirty rooms require reconstruction.

An electrical area also needs work.

Which comes first?

A construction-first approach may prioritize whatever work can begin fastest.

A backward-designed approach asks:

What prevents the greatest number of usable rooms from returning?

If one electrical dependency controls 120 otherwise usable rooms, that issue may deserve priority over cosmetic reconstruction inside ten heavily damaged rooms.

The difference is operational leverage.

Prioritize the work that unlocks the most useful building function—not simply the work that is easiest to finish.

Find the Reoccupancy Gate

Every operating area has one or more conditions that must be satisfied before it can return to use.

These are Reoccupancy Gates.

For an office floor, gates might include:

✓ Required electrical systems available

✓ Appropriate HVAC operation

✓ Access restored

✓ Required fire/life-safety systems addressed

✓ Restoration work appropriately separated

✓ Necessary repairs completed

✓ Applicable evaluations or inspections completed

Once all critical gates are satisfied, the area can move toward reoccupancy.

If one remains unresolved, that gate becomes the controlling dependency.

water damage repair restoration equipment home & buisness mitigation drying company (7)
Checking equipment and conditions in an active office space. Working backward from the reopening goal reveals which of these checks actually controls the date.

One Failed Gate Can Hold Back Everything Behind It

Imagine nine of ten necessary conditions are complete.

The tenth remains unresolved.

The area may still be unable to reopen.

This creates a frustrating commercial restoration reality:

90% ready can equal 0% usable.

The final unresolved gate could be:

  • Electrical service
  • Elevator availability
  • Fire alarm functionality
  • HVAC
  • Access
  • Plumbing
  • Specialized equipment
  • Required testing
  • Inspection

The remaining work may be physically small.

Its operational consequence can be enormous.

That’s why reoccupancy gates should be identified at the beginning of the project rather than discovered at the end.

Design the Last 10% During the First 10%

Commercial restoration naturally concentrates on immediate damage.

Extract the water.

Stabilize the building.

Protect contents.

Remove affected materials.

Those actions deserve urgency.

At the same time, someone should be asking:

“What could prevent us from reopening after all of this work is finished?”

That question identifies future bottlenecks while there is still time to solve them.

Maybe specialized electrical equipment has a long lead time.

Perhaps an elevator component requires evaluation.

An inspection could require advance scheduling.

Replacement glazing might need fabrication.

A building-control component could be difficult to obtain.

Discovering these issues during the final week creates delay.

Finding them during the first week creates options.

Reoccupancy Planning Should Begin During Emergency Response

It sounds premature to discuss reopening while crews are still extracting water.

Operationally, it isn’t.

Emergency response determines what gets protected.

Protection influences what remains usable.

Usability influences partial occupancy.

Partial occupancy influences business interruption.

Therefore, early decisions can have downstream consequences.

During emergency stabilization, ask:

— Which areas remain unaffected?

— Which systems serve them?

— What should be protected immediately?

— Which access routes must remain available?

— Can restoration activity be isolated?

— What temporary systems might preserve operations?

— Which damaged component controls the largest operating area?

Those questions begin the reoccupancy plan before reconstruction starts.

Protect the Future Operating Zone

Suppose 30% of a building is damaged.

Another 70% may potentially remain usable.

That 70% becomes extremely valuable.

Don’t allow the restoration project to unnecessarily consume it.

Protect:

Access

Air quality

Utilities

Elevators

Corridors

Customer pathways

Employee areas

Loading routes

Tenant entrances

Operational equipment.

This creates another backward-planning principle:

If an area is expected to support future partial occupancy, protect its ability to operate from Day 1. Property owners comparing options can look at warehouse drying and dehumidification to see where reoccupancy planning fits.

Partial Occupancy Should Be Designed, Not Discovered

Sometimes a commercial property reaches Week 3 before someone asks:

“Could we have kept the fourth floor open?”

By then:

Containment blocks the corridor.

Equipment occupies the elevator lobby.

Materials are staged in the access route.

Contractors use the only practical entrance.

The opportunity has disappeared.

Backward-designed recovery identifies potential operating zones before restoration logistics consume them.

That allows construction planning to preserve:

✓ Dedicated occupant access

✓ Separate contractor access

✓ Operational elevators

✓ Clean pathways

✓ Required utilities

✓ Environmental separation

Partial occupancy becomes an intentional recovery milestone rather than a lucky accident.

Temporary Infrastructure Can Create an Earlier Finish Line

Suppose permanent electrical repair requires four weeks.

Does that mean the business must remain closed for four weeks?

Not necessarily.

The better question is:

Is an appropriate temporary solution possible?

The same logic can apply to:

  • Power
  • Cooling
  • Heating
  • Lighting
  • Communications
  • Water
  • Office space
  • Storage
  • Access
  • Certain equipment

Temporary infrastructure does not replace permanent restoration.

It can create an intermediate operating condition.

Think:

Failure

→ temporary capability

→ partial operation

→ permanent repair

→ normal operation.

That intermediate step can have enormous economic value.

Backward Planning Reveals the Critical Path

Once the desired operating condition is defined, the project can identify the sequence controlling it.

Suppose a warehouse needs Dock 4 operational.

Working backward:

Dock 4 operating

requires

↓

material-handling access

requires

↓

electrical power

requires

↓

damaged distribution equipment restored

requires

↓

specialty component

requires

↓

procurement

requires

↓

specification confirmed today.

Suddenly, today’s most important restoration action may not involve demolition at all.

It may be confirming the specification of a component needed three weeks from now.

That’s the power of backward design.

Work Backward From Long-Lead Components

Commercial recovery schedules can be destroyed by components discovered too late.

Specialized electrical equipment.

Mechanical components.

Elevator parts.

Custom glazing.

Controls.

Specialty doors.

Commercial equipment.

Some replacement items cannot simply be purchased at a local store.

Backward planning asks:

When must this system operate?

Then:

When must installation occur?

Then:

When must the component arrive?

Then:

When must it be ordered?

Then:

What decision must happen before ordering?

This converts procurement from an administrative function into a recovery strategy.

Work Backward From Inspections and Verification

The same principle applies to required inspections, testing and specialized evaluations.

If reoccupancy depends upon a particular verification:

Reoccupancy date

↓

required verification

↓

prerequisite work completed

↓

documentation prepared

↓

inspection coordinated

↓

schedule established.

Waiting until construction finishes to discover the process can create unnecessary dead time.

A predictable requirement should be designed into the sequence from the beginning.

restoration vs repair vs mitigation commercial water damage drying company (10)
A large commercial floor mid-recovery. Reoccupancy planning designed from day one protects the areas capable of reopening soonest, instead of discovering them by accident.

Work Backward From Tenant Return

Tenant recovery has its own dependency chain.

Suppose a commercial tenant plans to return 80 employees.

Before that happens:

Employees need workstations.

Workstations require usable space.

Usable space requires utilities.

Utilities require building systems.

Employees require access.

Access may require elevators.

The tenant may need communications systems.

Restoration activity may need separation.

Furniture and equipment may need to return.

Now the reoccupancy date becomes a logistics event rather than simply a construction- completion date.

Backward planning makes those dependencies visible.

Work Backward From Customer Experience

Retail, hospitality and public-facing properties have another layer.

Technically open does not always mean commercially functional.

Imagine a hotel lobby is usable, but guests enter beside active demolition.

A retailer is open, but customers walk through construction staging.

A restaurant is operating, but restoration noise dominates the dining area.

These businesses need more than physical access.

They need an acceptable operating environment.

Therefore, the backward plan should ask:

What must customers experience when we reopen?

That answer can affect:

  • Work hours
  • Construction boundaries
  • Noise scheduling
  • Material staging
  • Access routes
  • Temporary entrances
  • Visual separation

Operational readiness includes the experience necessary for the business to function.

The Reoccupancy Map Should Be Different From the Damage Map

A damage map answers:

Where is the property affected?

A reoccupancy map answers:

Where can useful operations return—and what prevents the remaining areas from returning?

Those maps can look completely different.

RED — Active Restoration

Not currently available for normal use.

YELLOW — Reoccupancy Dependency

Physical damage may be limited, but unresolved systems or access conditions affect usability.

GREEN — Operational

Conditions support intended use.

BLUE — Temporary Operations

Area has been repurposed to support continuity during restoration.

Now the building becomes a dynamic recovery map.

As dependencies are resolved:

Red → Yellow → Green

and temporary areas can eventually return to normal use.

Reoccupancy Should Move Through Release Zones

Instead of one massive final release, large commercial properties can sometimes be divided into Reoccupancy Release Zones.

For example:

Release Zone 1

Critical operating area.

Release Zone 2

Priority revenue area.

Release Zone 3

Secondary operating space.

Release Zone 4

Remaining reconstruction area.

Each zone receives its own:

requirements

dependencies

restoration sequence

verification

release milestone.

This turns a six-month building restoration into a series of smaller operational victories.

A Hotel Should Recover Rooms, Not Just Square Footage

Consider a 300-room hotel.

Water damage directly affects 50 rooms.

If the restoration plan focuses only on square footage, the project may miss the most important business metric:

available room inventory.

Backward planning asks:

How quickly can we return 250 rooms?

Then:

Can we return another 20?

Then:

What controls the remaining 30?

Now the project is restoring revenue capacity in stages.

The same principle applies elsewhere.

Warehouse:

shipping capacity.

Manufacturing:

production capacity.

Office:

usable workstations or tenant floors.

Retail:

customer-accessible sales area.

Recovery should be measured in the language of the business.

Define the Minimum Viable Building

Technology companies talk about a minimum viable product.

Commercial recovery can use a similar idea:

What is the Minimum Viable Building required to restore useful operations?

Not the finished building.

Not the perfect building.

The minimum configuration that appropriately supports a defined business function.

For a warehouse, that might require:

Power + lighting + WMS + loading + safe access + fire/life safety + usable storage.

Administrative offices could remain under reconstruction.

For a hotel:

Guest access + utilities + elevators + life safety + available rooms + essential support operations.

Some amenities might remain unavailable temporarily.

This concept helps separate:

required for operation

from

required for complete restoration.

Minimum Viable Building Does Not Mean Minimum Standards

The phrase should not be misunderstood.

It does not mean cutting corners.

It means identifying the smallest portion or configuration of the property that can appropriately support a meaningful operation while remaining restoration continues elsewhere.

All necessary conditions still matter.

The advantage is strategic:

Don’t wait for noncritical completion if a properly functioning portion of the building can return sooner. Large warehouse water damage adds another layer to reoccupancy planning that is easy to underestimate.

That can dramatically change business interruption.

Use the Reoccupancy Critical Path

Traditional project schedules identify construction dependencies.

Commercial recovery can identify a Reoccupancy Critical Path.

Example:

Reopen Office Floors 7–10

requires

↓

Elevator service

requires

↓

Elevator control evaluation

requires

↓

Electrical restoration

requires

↓

Replacement component

requires

↓

procurement

requires

↓

authorization/specification.

That entire chain may be controlled by a decision needed today.

Everything else can look nearly complete while this one chain controls occupancy.

The critical path should therefore be visible to everyone managing the recovery.

Find the Reoccupancy Choke Point Every Day

Yesterday’s bottleneck may not be today’s bottleneck.

Once electrical service returns, elevator testing might become the controlling dependency.

After elevators return, fire/life-safety work may become critical.

Once that is resolved, tenant access logistics may control the next milestone.

The recovery team should continuously ask:

“What single unresolved condition currently prevents the next important area from returning to use?”

That is the Reoccupancy Choke Point.

Resolve it.

Then ask again.

A Reoccupancy Countdown Can Focus the Entire Project

Instead of reporting only:

Demolition 100%

Drying 100%

Drywall 80%

Painting 45%

add another view:

Reoccupancy Milestone: Floor 8

5 dependencies remaining

Yesterday: 7

Today: 5

Reoccupancy Milestone: Shipping Operations

2 dependencies remaining

Yesterday: 3

Today: 2

This shifts the conversation from construction activity to operational readiness.

The objective becomes eliminating dependencies.

Reoccupancy Dependency Burn-Down

This creates another useful measurement.

At the beginning:

23 unresolved dependencies.

After stabilization:

18.

After systems evaluation:

13.

After drying:

9.

After reconstruction:

4.

After verification:

0.

Now the area can return to use.

This is a Reoccupancy Dependency Burn-Down.

The metric does not replace construction progress.

It explains how close the property is to becoming useful again.

Documentation Should Support Reoccupancy Decisions

The decision to return an area to use should not depend on vague statements such as:

“It looks pretty much finished.”

Documentation can organize the evidence supporting the milestone.

Depending upon the project, that might include:

  • Restoration records
  • Moisture documentation
  • System evaluations
  • Repair records
  • Photographs
  • Testing
  • Inspection information
  • Completion records
  • Outstanding-condition lists

The exact requirements vary.

The principle remains:

Reoccupancy should be supported by a traceable recovery record.

Create a Reoccupancy Readiness Matrix

A large property can track readiness by area.

AreaPhysical RestorationUtilitiesAccessCritical SystemsVerificationOperational Status
Floor 2ActivePartialRestrictedPendingPendingClosed
Floor 3CompleteAvailableAvailablePendingPendingHold
Floor 4CompleteAvailableAvailableAvailableCompleteOperational
Floor 5UnaffectedAvailableAvailableAvailableCompleteOperational

The exact categories should reflect the property.

The value comes from immediately seeing why an area isn’t ready.

Instead of saying:

“Floor 3 is still closed.”

the team can say:

“Physical restoration is complete; one critical-system dependency remains.”

That is actionable information.

Work Backward Every Morning

Backward-designed recovery is not merely something created during the first planning meeting.

Use it daily.

Start with:

What is the next operational milestone?

Then:

What prevents it?

↓

What does that dependency require?

↓

Who owns it?

↓

What must happen today?

Then ask:

What milestone comes after that?

Now today’s restoration work remains connected to tomorrow’s business objective.

Different Commercial Properties Need Different Backward Plans

Hotel

Guest occupancy

← room availability

← utilities and access

← building systems

← restoration.

Warehouse

Shipping

← loading capability

← material handling

← WMS and communications

← power

← infrastructure restoration.

Manufacturing

Production

← critical equipment

← process utilities

← controls

← electrical/mechanical systems

← restoration.

Office Building

Tenant occupancy

← usable workspace

← elevators/access

← HVAC/electrical/communications

← shared building systems

← restoration.

Retail

Customer operations

← safe customer environment

← access

← utilities

← sales-floor readiness

← restoration.

Different businesses create different finish lines.

Therefore, they should create different recovery sequences.

Reoccupancy Planning Changes the Definition of Speed

Without a reoccupancy strategy, speed is often measured as:

How quickly is construction progressing?

Backward design asks:

How quickly are operating capabilities returning?

Those measurements can diverge.

A project can perform enormous amounts of construction without returning one additional dollar-producing area to service.

Another project may deliberately restore one critical dependency and return half the building to operation.

Which one is actually recovering faster?

For commercial properties, the second measurement often matters more.

Recovery Should Be Designed From Both Ends

Commercial restoration still has to begin at the damage.

Emergency conditions cannot be ignored because a future operating goal exists.

The strongest strategy therefore works from both directions.

Forward From the Loss

Damage

→ stabilization

→ investigation

→ mitigation

→ restoration.

Backward From Reoccupancy

Desired operation

← occupancy requirements

← operational dependencies

← building systems

← construction requirements.

Eventually, the two paths meet.

That meeting point reveals the most important restoration priorities.

Forward planning tells you what the damage requires. Backward planning tells you what the business requires. For operators of big-box and industrial sites, commercial warehouse restoration shows how reoccupancy planning plays out at scale.

Commercial recovery needs both.

The Finish Line Should Determine the Route

Commercial property damage creates urgency.

Water needs to be controlled.

Damaged areas need investigation.

Materials need to dry.

Systems need evaluation.

Reconstruction needs to occur.

All of that remains true.

But none of those activities should cause the project to lose sight of why the building is being restored in the first place.

The objective is not drywall.

The objective is not flooring.

The objective is not equipment removal.

Those are means.

The real destination is useful building function.

So define that destination early.

What does reopening actually mean?

Which portion of the property needs to return first?

What systems make that possible?

What construction supports those systems?

What unresolved condition controls the milestone?

What must happen today so that condition does not become tomorrow’s delay?

Then work backward until the answer reaches the work happening right now.

That creates the complete chain:

REOCCUPANCY

↓

OPERATIONAL FUNCTION

↓

DEPENDENCIES

↓

BUILDING SYSTEMS

↓

CONSTRUCTION

↓

RESTORATION

↓

TODAY’S ACTION

Commercial restoration traditionally asks:

“How do we get from the damage to the finished building?”

Backward-designed recovery adds a second question:

“What does the finished building need to do—and what must happen today to make that possible?”

That is the difference between repairing a property and designing its recovery.

Start with the finish line. Then build the recovery backward.
